Updating As-Built Models: When & How Often

One of the quiet killers of BIM credibility on construction projects is the outdated as-built model.

· BSMA Enterprises

3DScanning, AEC, BIM, ConstructionTechnology, DigitalTwins, FieldworkChallenges, GeospatialTechnology, RealityCapture

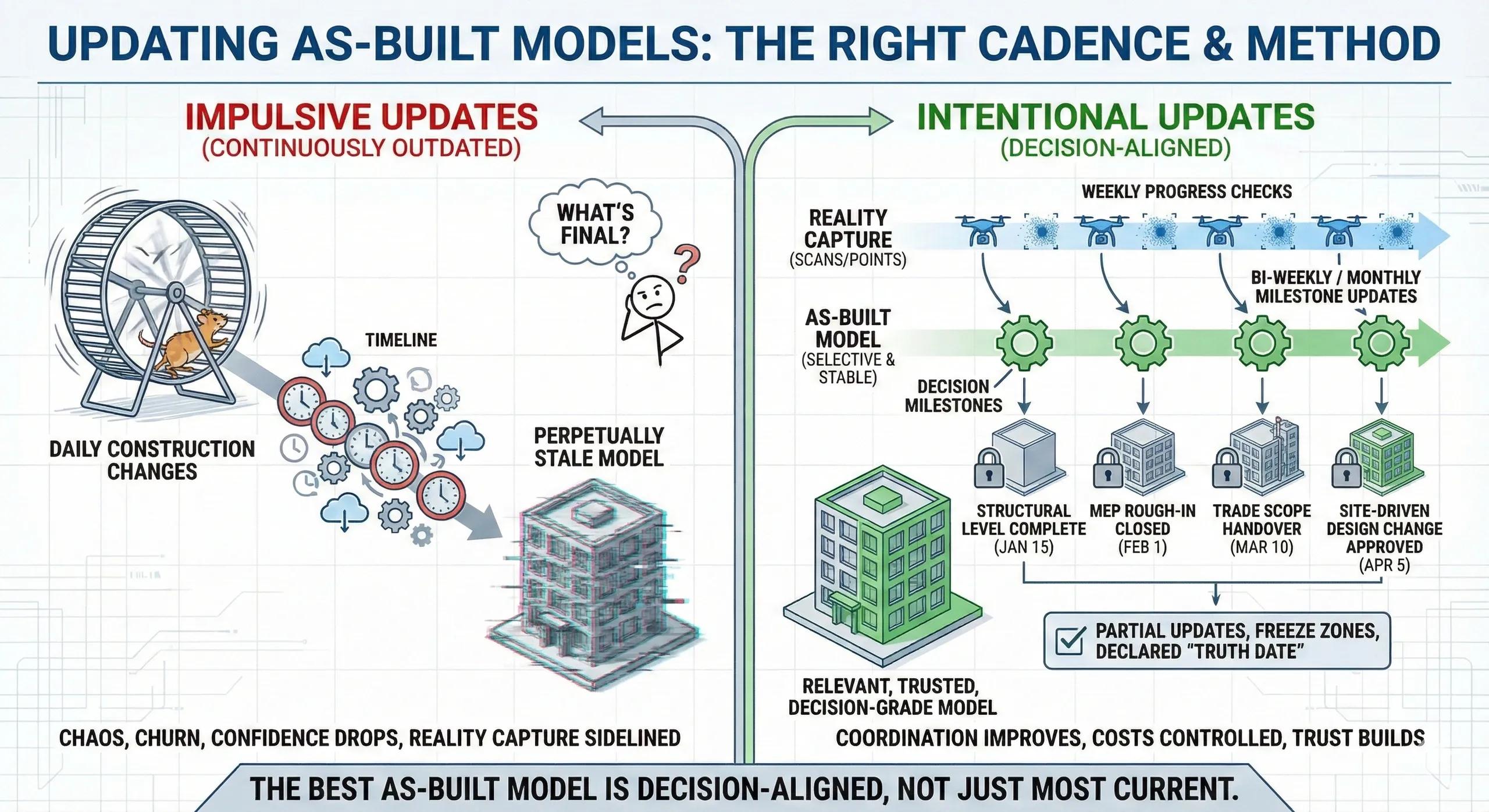

As-built models should follow decisions, not daily site chaos (Illustrative visualization for conceptual purposes).

One of the quiet killers of BIM credibility on construction projects is the outdated as-built model .

Teams invest in scans, modeling, and coordination, only to realize weeks later that the “as-built” model no longer reflects site reality. At that point, trust erodes. People stop opening the model. Screenshots replace data. Decisions revert to gut feel.

The issue is rarely how as-built models are updated.

It is when and how often they are updated.

This article explains how to define the right update cadence for as-built models so that BIM remains usable, trusted, and decision-grade throughout construction.

1. The Myth of the Continuously Updated As-Built

Many projects aim for a continuously up-to-date as-built model.

In practice, this fails because:

Construction changes daily

Modeling lags reality

Approval cycles slow updates

Teams disagree on “what’s final”

Trying to update everything all the time produces perpetually stale models .

As-built updates must be intentional , not constant.

2. As-Built ≠ Reality Snapshot

A key distinction:

Reality data (scans, point clouds) can be frequent

As-built models should be selective and stable

Reality data captures what exists now .

As-built models represent what is agreed and locked .

Confusing the two leads to chaos.

3. Update Frequency Depends on Decision Cycles

As-built models should update in sync with decision milestones , not capture frequency.

Typical patterns:

Weekly → Reality capture (progress, deviation checks)

Bi-weekly / Monthly → Selective model updates

Milestone-based → Structural, MEP, and system lock-ins

Updating models without a decision trigger adds cost, not value.

4. What Should Trigger an As-Built Update

Valid triggers include:

Completion of a structural level

Closure of MEP rough-in zones

Approval of site-driven design changes

Resolution of deviation beyond tolerance

Handover of a trade scope

Invalid triggers:

Minor temporary changes

Early-stage installations

Provisional routing

Only accepted reality belongs in the as-built model.

5. Partial Updates Beat Full Rebuilds

As-built updates should be zone-based , not global.

Best practice:

Update only affected levels or areas

Freeze completed zones

Avoid reprocessing the entire model

This keeps:

Update cycles short

Model stability high

Coordination focused

6. As-Built Models Must Declare Their “Truth Date”

Every as-built model must answer one question clearly:

As built… as of when?

Without a declared timestamp:

Models get misused

Coordination errors multiply

Claims become ambiguous

Time-stamping builds trust.

7. Handling Deviations Without Remodeling Everything

Not every deviation requires geometry changes.

Use:

Deviation reports

Metadata notes

Linked snapshots

Remodel only when:

Design intent changes

Downstream work depends on it

This avoids unnecessary churn.

8. As-Built Updates in the Indian Context

On Indian sites:

Design evolves during execution

Approval cycles vary

Cost sensitivity is high

A practical strategy:

Keep BIM lean during execution

Rely on scans for weekly control

Update models at contractual or trade milestones

This balances accuracy with affordability.

9. As-Built Models for Handover vs Construction

Construction-phase as-built models are working models .

Handover as-built models are records of responsibility .

Do not force construction models to serve both purposes simultaneously.

Define:

Construction as-built cadence

Final handover modeling scope

Upfront clarity prevents conflict.

10. A Simple Update Rule

Before updating an as-built model, ask:

What decision will this updated geometry enable that the current model cannot?

If the answer is unclear, wait.

Conclusion

As-built models lose value not because they are inaccurate, but because they are out of sync with decision-making .

When updated intentionally:

BIM stays relevant

Teams trust the model

Coordination improves

Costs stay controlled

When updated impulsively:

Models churn

Confidence drops

Reality capture gets sidelined

In BIM-to-field workflows, the best as-built model is not the most current one, it is the most decision-aligned one .
