MEP Modeling from Scans: What Makes It Hard

If structural Scan-to-BIM fails because of over-modeling, MEP Scan-to-BIM fails because of complexity.

· BSMA Enterprises

3DScanning, AEC, AI, BIM, ConstructionTechnology, DigitalTwins, FieldworkChallenges, GeospatialTechnology, RealityCapture

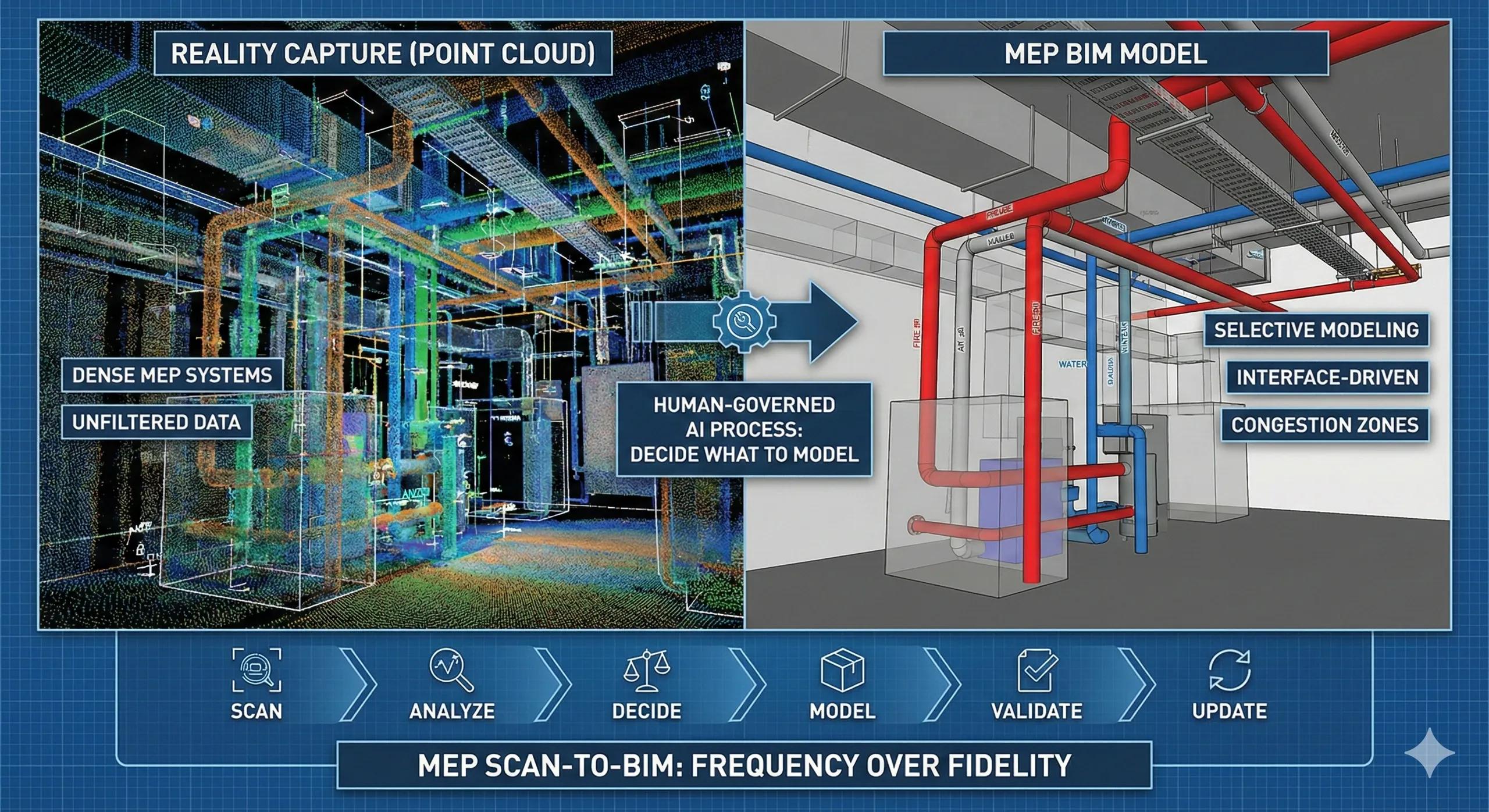

In MEP, modeling everything is the fastest way to slow down (Illustrative visualization for conceptual purposes).

If structural Scan-to-BIM fails because of over-modeling, MEP Scan-to-BIM fails because of complexity .

MEP systems are dense, layered, multi-trade, and installed in sequences that rarely match design intent. Scans capture this reality perfectly, pipes crossing out of plane, ducts offset for site constraints, trays adjusted to avoid clashes. The challenge is not seeing this complexity. The challenge is deciding what to model, how much to model, and when modeling actually adds value .

This article breaks down why MEP modeling from scans is hard, and how to approach it without drowning in geometry.

1. Why MEP Is the Hardest Scan-to-BIM Domain

MEP systems differ fundamentally from structure:

Multiple trades in the same volume

Tight clearances and tolerance sensitivity

Late design changes and site adjustments

Temporary routing during installation

Frequent rework and re-sequencing

Scans capture everything . BIM needs selective abstraction . The gap between the two is widest in MEP.

2. The Biggest Mistake: Modeling Every Detected Pipe and Duct

AI and manual workflows can now detect most MEP elements from scans. The mistake is assuming detection equals value.

Modeling everything leads to:

Bloated federated models

Slow updates

Constant rework as routing changes

Confusion about what is “approved”

MEP Scan-to-BIM must start with scope boundaries , not geometry.

3. Decide First: What Decision Will This MEP Model Support?

Before modeling, ask:

Is this for clearance validation ?

Is it for clash resolution with downstream trades ?

Is it for handover and O&M ?

Is it for progress verification only ?

Each purpose implies a different modeling depth.

If the decision is visual awareness or progress tracking, the point cloud is often enough .

4. Why Tolerances Matter More in MEP Than Structure

MEP failures cascade.

A 20 mm offset in a column may be acceptable. A 20 mm offset in a duct can break:

Ceiling coordination

Fire clearance

Maintenance access

This is why:

MEP modeling must be interface-driven

Not all runs need the same precision

Critical zones deserve modeling priority

5. Congestion Zones vs Transit Zones

Not all MEP areas are equal.

Congestion Zones

Shafts

Plant rooms

Ceiling voids with multiple systems

These zones benefit from:

Accurate modeling

Clearance envelopes

Explicit routing geometry

Transit Zones

Long straight runs

Single-trade corridors

Here, scans or simplified centerlines are often sufficient.

Model where risk concentrates, not where geometry is easy.

6. Modeling Systems vs Modeling Geometry

Another common failure is focusing on shape instead of system logic.

A pipe model is useless if:

System type is wrong

Flow direction is unknown

Isolation boundaries are missing

For MEP, metadata often matters more than exact geometry , especially for handover.

7. AI Helps, But Only Partially

AI feature extraction works best for:

Identifying candidate elements

Pre-classifying pipes, ducts, trays

Speeding up repetitive modeling

AI struggles with:

System intent

Temporary vs permanent routing

Trade responsibility

Construction sequence logic

MEP Scan-to-BIM must remain human-governed .

8. Frequency Over Fidelity

In active installation phases:

Weekly alignment checks matter

Monthly “perfect” models arrive too late

Lean MEP models updated frequently outperform detailed models updated slowly.

9. When NOT to Model MEP from Scans

Avoid modeling when:

Routing is still changing

Systems are incomplete

Install is provisional

The model won’t drive a decision

Use:

Point clouds for awareness

Deviation reports for control

10. A Practical MEP Scan-to-BIM Rule

Model only what another trade, inspection, or downstream decision depends on.

Everything else stays in reality data.

Conclusion

MEP Scan-to-BIM is hard not because scans are inaccurate, but because MEP decisions are context-sensitive .

When done right:

Congestion risks reduce

Coordination improves

Rework drops

BIM earns trust

When done wrong:

Models bloat

Updates lag

Teams revert to screenshots

In BIM-to-field workflows, MEP modeling succeeds when restraint is treated as a skill, not a compromise .
